Central Pike (State Route 265)

Wilson County
Wilson SR 265

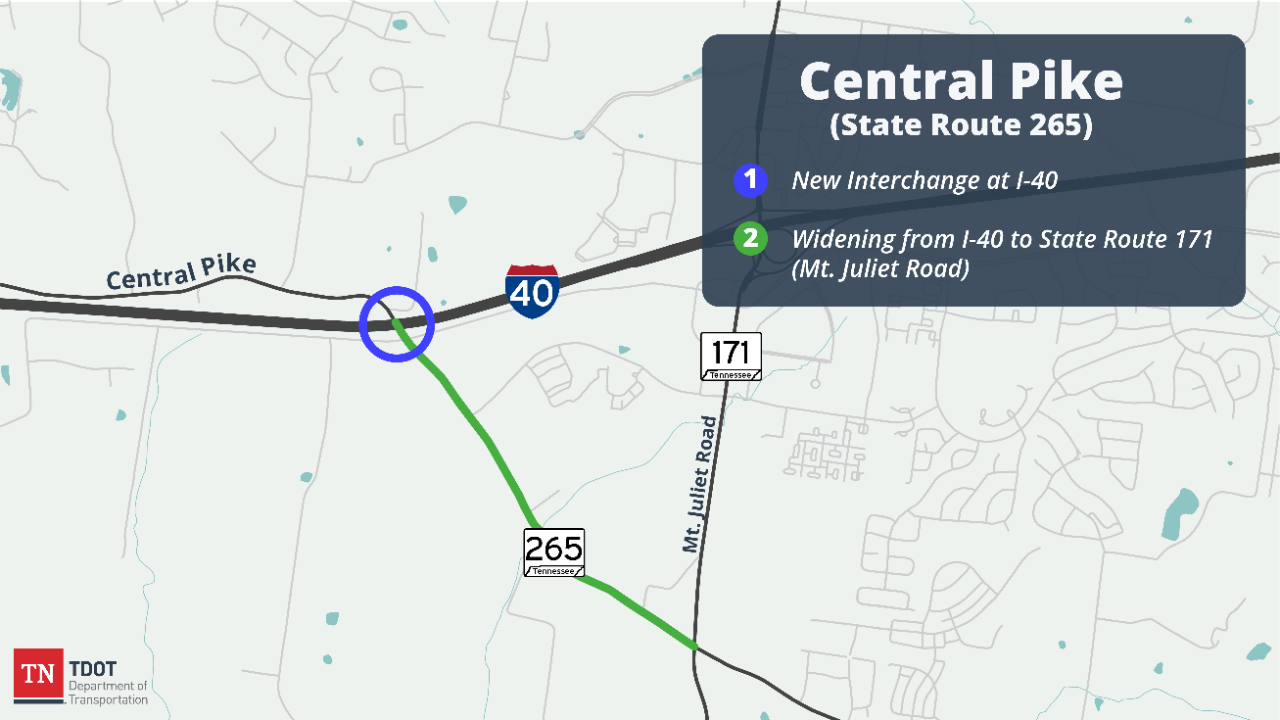

The Tennessee Department of Transportation (TDOT), alongside the City of Mount Juliet, plans to construct improvements to the Central Pike (State Route 265) corridor in Wilson County. Two projects are currently scheduled for funding in TDOT’s 10-Year Project Plan: A new interchange at Central Pike and Interstate 40 and widening of Central Pike from the proposed interchange to Mt. Juliet Road (State Route 171).

These projects will provide additional capacity, as well as operational and safety benefits along a heavily traveled corridor in a part of Middle Tennessee experiencing new growth and development. Both projects are the result of a partnership between TDOT and the City of Mt. Juliet, which is funding a portion of both projects.

Current Status: Preliminary engineering is underway for the interchange at I-40 and Central Pike. The City of Mt. Juliet is managing preliminary engineering for the widening of Central Pike.

Estimated construction start: Both projects are scheduled in TDOT’s 10-Year Project Plan to begin construction in Fiscal Year 2030.

Estimated completion*: TBD

Funding Type: The interchange at I-40 and Central Pike is funded through the Statewide Partnership Program. The City of Mt. Juliet is contributing a portion of the project’s funding, with the remainder funded through the Transportation Modernization Fund and traditional federal and state sources. Mt. Juliet is managing and funding preliminary engineering for the widening of Central Pike, with the remaining phases managed by TDOT and funded through traditional federal and state sources.

magnifying glass


History and Background

Interchange at I-40 and Central Pike

TDOT initiated study of a request for new interchange access on I-40 at Central Pike at the request of the Nashville Area Metropolitan Planning Organization (MPO), the City of Mt. Juliet, and Wilson County. TDOT gained conceptual approval of the Interchange Access Request from the Federal Highway Administration in November 2017. TDOT developed a Technical Planning Report in September 2022 for the entire corridor.

In 2023, Mt. Juliet submitted this project to TDOT as a potential Statewide Partnership Program project, whereby the city would contribute local funding and support to accelerate a project on TDOT’s system. TDOT review indicated that this project was a strong candidate, and the project is identified for funding in TDOT’s current 10-Year Project Plan.

The proposed design for the interchange is a diverging diamond interchange (DDI). The unique crisscross design of a DDI allows two directions of traffic to temporarily cross to opposite sides of the roadway in order to travel across the overpass, and then cross back and resume the original travel pattern. The DDI uses concrete dividers, stop bars, traffic signals, and extensive signage to guide motorists through the interchange. The DDI was selected to accommodate the large anticipated left-turn volumes from SR 265.

SR 265 will be improved within the interchange area from two travel lanes to four, with additional turn lanes and associated signalization. Side road improvements will also be constructed that accommodate proposed developments. Sidewalks will be provided.

Central Pike Widening

The footprint of this project stretches from the proposed interchange at I-40 to Mt. Juliet Road (SR 171). The current roadway includes one travel lane in each direction; the proposed project will widen Central Pike to five lanes (two travel lanes and a center turn lane). The project will address current and anticipated future congestion along the I-40, SR 265 and SR 171 corridors by improving a needed corridor between these heavily congested routes.

Mt. Juliet is managing the preliminary engineering (design and environmental review) portion of this project, as well as contributing some funding for right-of-way acquisition. TDOT will manage the right-of-way and construction phases.

people


Public Involvement and Engagement

Interchange at I-40 and Central Pike

A Design Public Meeting was held February 29, at Providence Church, 2293 S. Rutland Road, Mt. Juliet, TN 37122. Click here for meeting materials and presentation.

globe


Environment

Interchange at I-40 and Central Pike

In accordance with the National Environmental Policy Act (NEPA), a D-List Categorical Exclusion document was completed on December 15, 2023.

Project Contacts

Rebekah Hammonds
TDOT Region 3 Regional Communications Officer (Media)
Email: Rebekah.hammonds@tn.gov

Jon Storey, PE, PTOE
TDOT Region 3 Project Management Director
Email: jon.storey@tn.gov
Phone: 615.350.4300

Bradley Martin
TDOT Region 3 Project Management

Email: Bradley.martin@tn.gov

*Subject to change
